Case Study: Project CleanPulse
Case Study: Project CleanPulse

Rescuing a Medical RF Generator Before OEM Validation Failure

A medical device OEM was preparing a compact RF generator for prototype validation. The original RF core showed unstable pulsed output, harmonic leakage, internal chassis loss, and rising thermal drift inside the sealed enclosure. Our factory replaced the unstable RF chain with a controlled solid-state RF energy core built for clean spectrum, fast pulse response, hardware protection, and standardized OEM integration.

Mission Context

Medical RF Generator Validation Was Blocked

During internal validation, the customer’s prototype generator showed four simultaneous failure symptoms: pulse-edge current shock at PA enable, harmonic leakage around the intended RF output, measurable power loss before the front-panel output, and continuous heat accumulation inside the sealed chassis. The issue was no longer a component replacement problem. It required a controlled RF core redesign.

Complex Lab Setup representing OEM validation pressure

Before redesigning the entire generator, the OEM needed to identify whether the RF core itself could be stabilized.

View the Controlled Replacement Plan
System Breakdown

Why the First Medical RF Prototype Could Not Move Forward

TThe first prototype could generate RF power, but it could not keep that power stable, clean, and deliverable inside a compact medical generator chassis.

Engineering blueprint and failed hardware analysis
01

Pulse Enable Stress Was Ignored

The original design focused solely on rapid PA toggling, ignoring the massive transient shocks along the bias circuit during dense PWM operations. This continuous bombardment degraded the energy chain, risking unpredictable drops in validation performance.

The RF core could switch fast, but not safely.
02

RF Power Was Lost Inside the Chassis

Raw PA output looked sufficient during bench testing. But after isolators, coaxial transitions, couplers, and front-panel routing, the delivered output dropped below the OEM target.

The PA could generate power, but the chassis could not deliver it.
03

Heat Built Up in the Sealed Enclosure

The legacy core passed short open-bench tests, but failed under the airflow limits of a clinical desktop enclosure. Heat accumulation caused drift and triggered protection behavior.

It passed short tests, but failed the real enclosure condition.

Before redesigning the entire generator, the OEM needed to identify whether the RF core itself could be stabilized.

View the Controlled Replacement Plan
Execution Strategy

Controlled Replacement Matrix:
Turning RF Failure Findings Into Engineering Actions

Each audit finding was mapped to a specific RF-core requirement, factory response, and validation method — allowing the OEM to rebuild the unstable RF section without redesigning the entire medical generator.

Failure Symptom
Engineering Requirement
Factory Response
Validation Method
Pulse edge stress
Safe PWM switching
Protected PA enable / bias logic
Oscilloscope edge test
Front-panel power drop
Deliverable RF output
Gain correction + controlled RF path
PA vs front-output comparison
Harmonic leakage
Clean medical RF spectrum
Linearized RF chain + filtering
Spectrum analyzer proof
Sealed-chassis heat rise
Stable thermal operation
Efficient RF core + thermal base path
Long-run thermal imaging
Integration delay
Fast OEM control adoption
D-Sub / RS485 / alarm feedback
Command and fault-state test
Audit Findings Locked
RF Core Requirements Defined
Controlled RF Core Selected
Interface Matched
Bench Validated
OEM Prototype Rebuilt

The replacement plan focused on preserving the OEM’s system architecture while rebuilding the unstable RF energy chain.

See Core Solution 1
Core Solution 1

Rebuilding the Pulse-Controlled RF Output Path

The original PA could produce power, but the generator could not deliver it repeatably. We rebuilt the RF path around solid-state pulse control, gain compensation, and front-panel output verification.

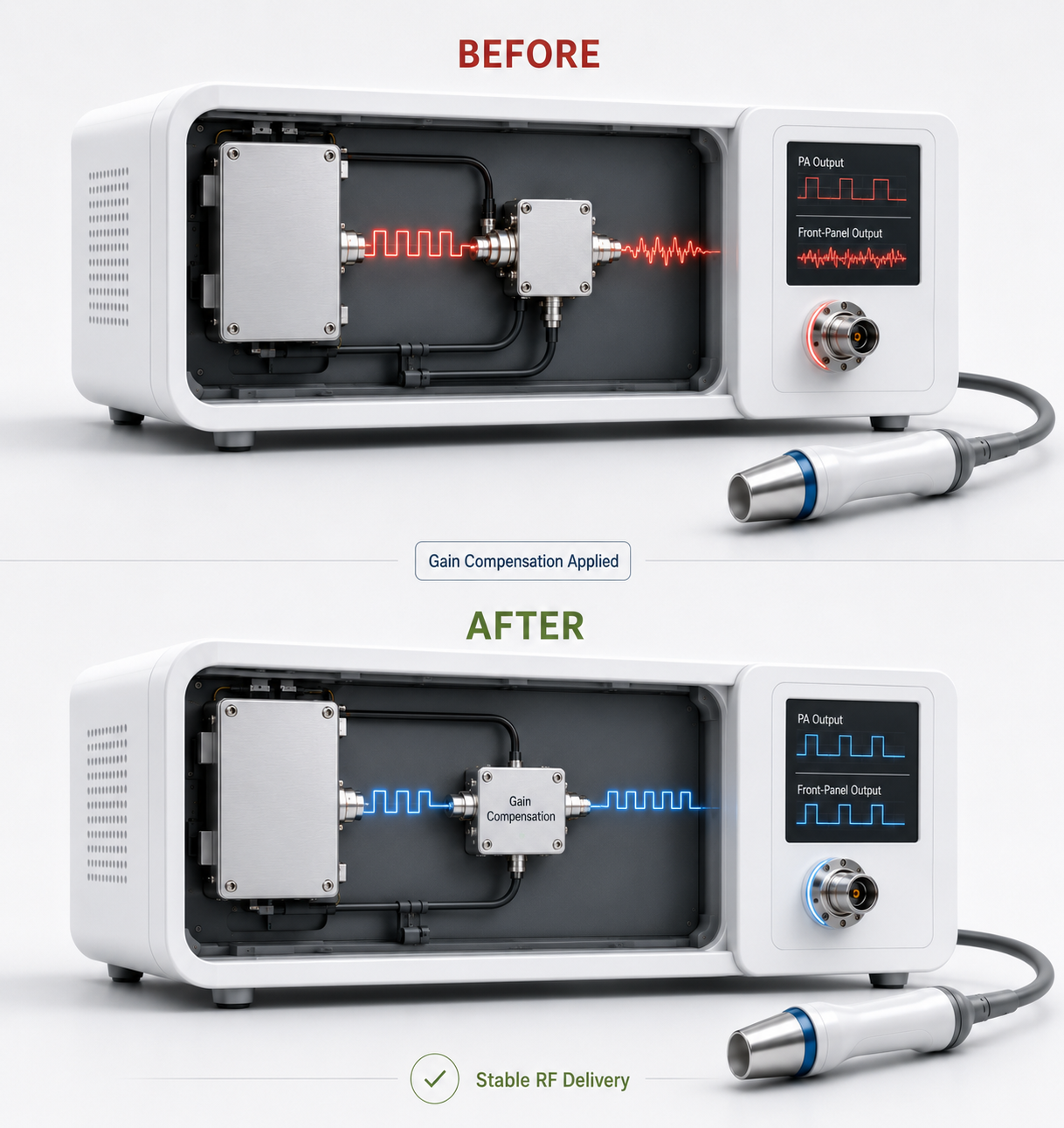

Precision measurement and stable RF path

Solid-State PA Switching

The enable path was rebuilt for controlled PWM operation. Fast PA switching remained available, but the bias circuit was no longer exposed to unmanaged pulse-edge stress.

Fast switching became controlled switching.

Gain Compensation for RF Path Loss

The RF output was calibrated across the full internal path, not only at the PA node. Gain correction helped recover the power lost through cables, couplers, and front-panel routing.

The target was repeatable generator output, not maximum PA output.

Verified Front-Panel Delivery

The RF chain was treated as one delivery system from PA output to applicator connector. Final validation was based on the front-panel output point the OEM actually uses.

Every RF transition became part of the delivery path.

Need a pulse-controlled RF core for a compact medical generator? Review our solid-state RF module platform before moving to protection logic.

View RF Core Modules
Core Solution 2

Fail-Safe RF Core Protection Under Mismatch and Heat

Once the output path was stabilized, the next risk was survival under abnormal load. We added hardware-level protection for VSWR, reflected power, temperature, voltage, current, shutdown, alarm feedback, and reset logic — so the OEM controller could react before the RF core was damaged.

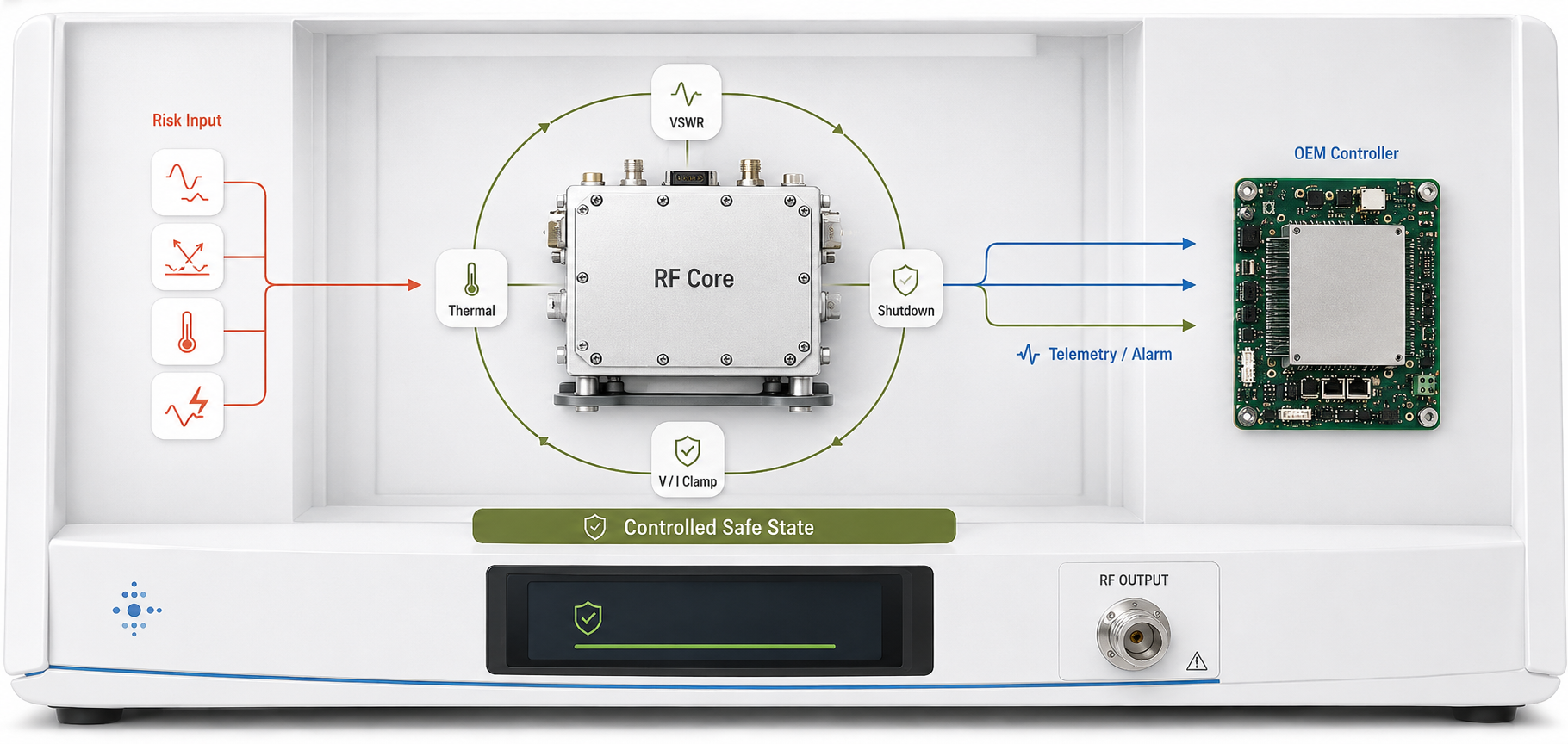

Hardware-level RF core protection logic for medical RF generator

VSWR Autolock for Load Mismatch

Open-load, short-load, and applicator mismatch events can send reflected energy back into the PA stage. The replacement RF core used hardware-level VSWR detection to trigger alarm and shutdown before reflected power could escalate into device failure.

Reflected power became a controlled fault state, not a destructive surprise.

Thermal Interlock for Sealed Medical Enclosures

The customer’s desktop generator had limited airflow and compact internal spacing. Thermal monitoring and interlock logic allowed the RF core to enter a safe state under heat accumulation, instead of drifting silently during long operation.

The RF core had to survive the enclosure, not only the open-bench test.

Voltage / Current Telemetry for OEM Control

Forward power, reflected power, voltage, current, temperature, alarm, shutdown, and reset states were exposed to the OEM controller. The RF section became a readable subsystem instead of a blind amplifier block.

The OEM controller no longer had to guess the RF core status — it could read it.

Second objective: make the RF core enter a controlled safe state under mismatch, thermal rise, or unstable supply conditions.

Calculate Thermal & Size Fit
Core Solution 3

Standardizing the RF Core for OEM Control Integration

The OEM did not want to redesign the whole generator controller. We standardized the RF core interface so the existing mainboard could control gain, read alarm states, receive telemetry, and manage shutdown/reset logic through a clean production-ready harness.

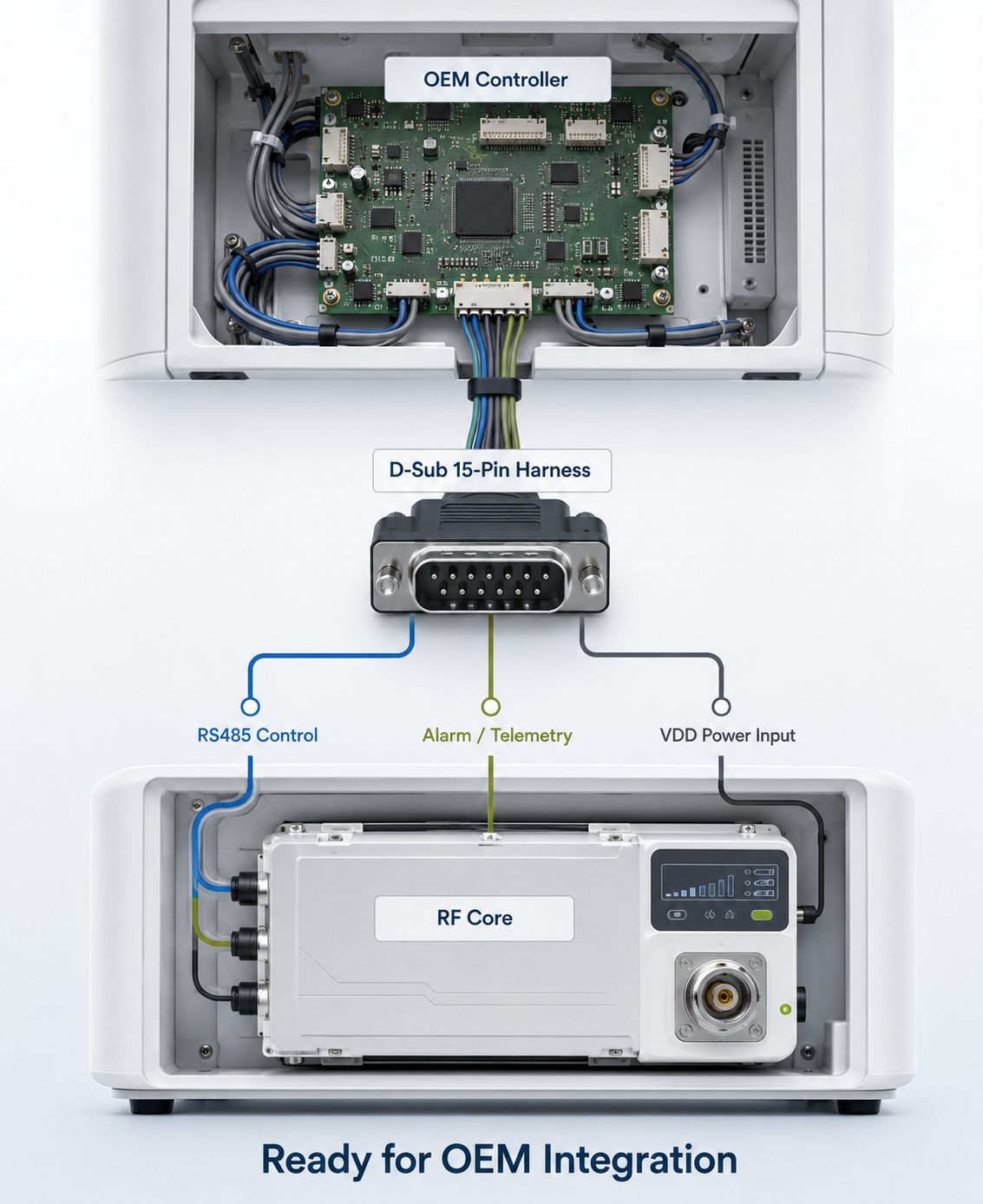

Standardized OEM control integration architecture for medical RF generator

D-Sub 15-Pin Control Harness

Enable, alarm, reset, telemetry, and control signals were organized into a defined D-Sub harness. This reduced prototype wiring uncertainty and gave the OEM a repeatable interface for future assembly.

The RF core became a defined subsystem, not a loose collection of signals.

RS485 / Modbus Control Path

Serial communication allowed the OEM controller to read RF core status and adjust operating parameters without rebuilding the main control architecture.

The OEM controller could command the RF section instead of only powering it.

Separated Power and Signal Routing

VDD power input, RF output, and control communication were routed as separate paths. The internal wiring became cleaner, easier to service, and better prepared for pilot production.

The wiring was redesigned for production serviceability, not just prototype function.

Third objective: let the OEM keep its controller while gaining command, alarm, telemetry, and reset access to the RF core.

View Signal Verification

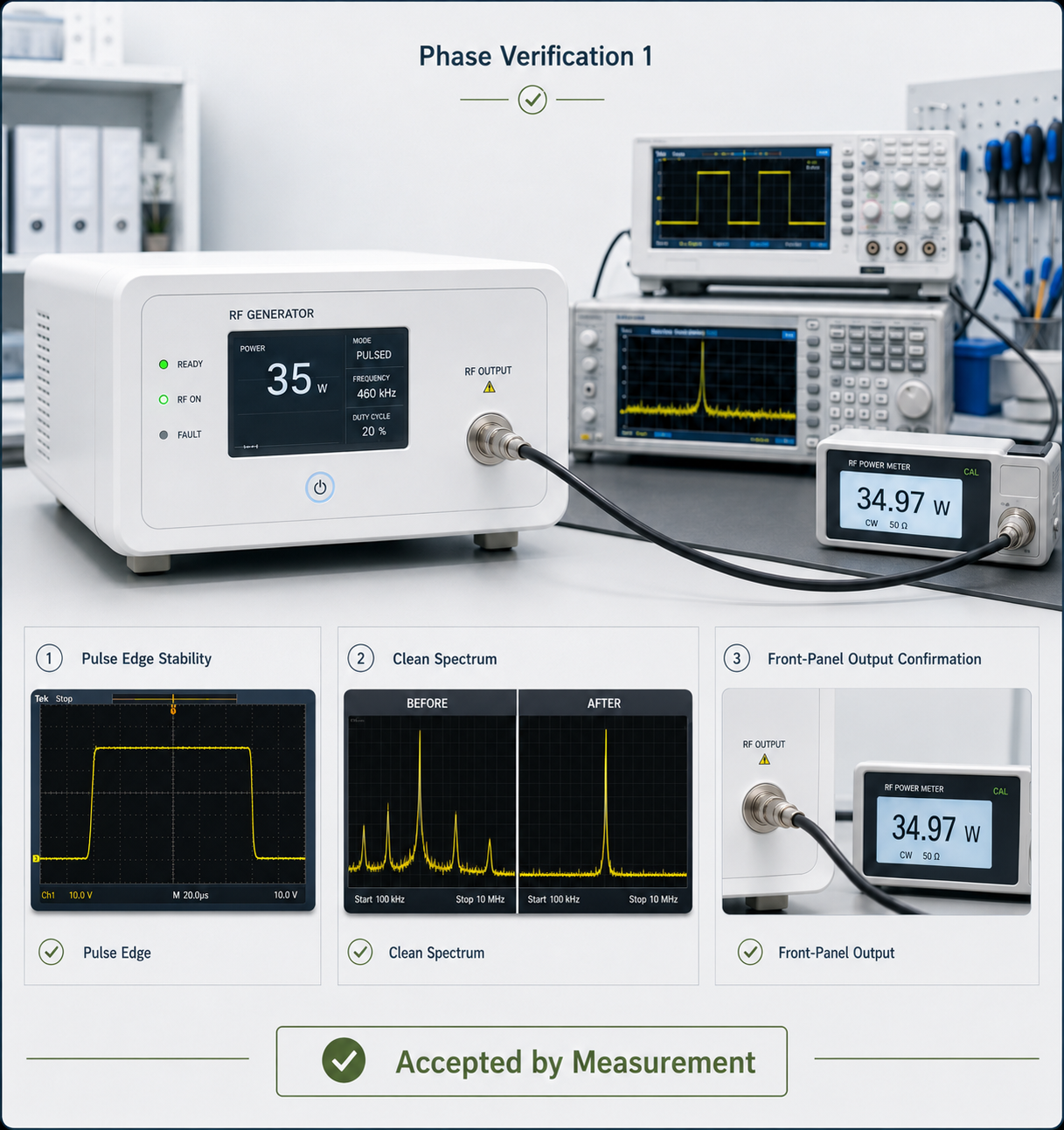

Phase Verification 1

Proving Clean Spectrum and Stable Pulsed Output

After the replacement RF core was installed, the first acceptance step was objective measurement. The OEM reviewed pulse behavior, spectrum cleanliness, and front-panel output delivery before moving the prototype into the next validation phase.

Engineer verifying RF spectrum and oscilloscope waveforms
01

Pulse Edge Stability

The pulsed RF output was checked on the oscilloscope after the new core was installed. Rise and fall behavior became repeatable, with reduced overshoot and ringing during enable / disable operation.

Pulse behavior became measurable and repeatable.
02

Harmonic Suppression

Spectrum review confirmed that harmonic and spurious peaks were reduced around the intended RF output. This gave the OEM a cleaner signal baseline for further EMC and system validation.

The RF signal was accepted by spectrum evidence.
03

Front-Panel Output Confirmation

Output was verified at the generator connector, not only at the PA node. This confirmed that the corrected RF path could deliver repeatable power at the point used by the OEM system.

The final check moved to the output point the OEM actually uses.

The replacement RF core was accepted through measured waveform, spectrum, and output-path evidence — not by claim.

View Chassis Validation
Phase Verification 2

Validating the RF Core Inside the Real Medical Chassis

After signal verification, the RF core was checked inside the customer’s real generator chassis. Mounting, cable routing, thermal contact, airflow limits, and front-panel output geometry were verified as part of the physical system.

1

Mechanical Fit and Mounting Interface

The RF core was checked against the customer’s chassis space, mounting holes, connector direction, and service clearance. The goal was to fit the existing generator structure without forcing a full mechanical redesign.

The RF core had to fit the generator, not force the generator to be rebuilt.

2

Thermal Contact and Heat Path

Thermal contact was verified through the module base, chassis contact surface, and airflow-limited enclosure condition. The focus was to confirm that heat could leave the RF core under real generator constraints.

Thermal performance was verified through the customer’s real enclosure constraints.

3

Cable Routing and Serviceability

RF coaxial lines, VDD power wiring, and control harnesses were routed as separate serviceable paths. This reduced layout uncertainty and made the prototype easier to repeat in later builds.

A stable prototype must also become a repeatable assembly.

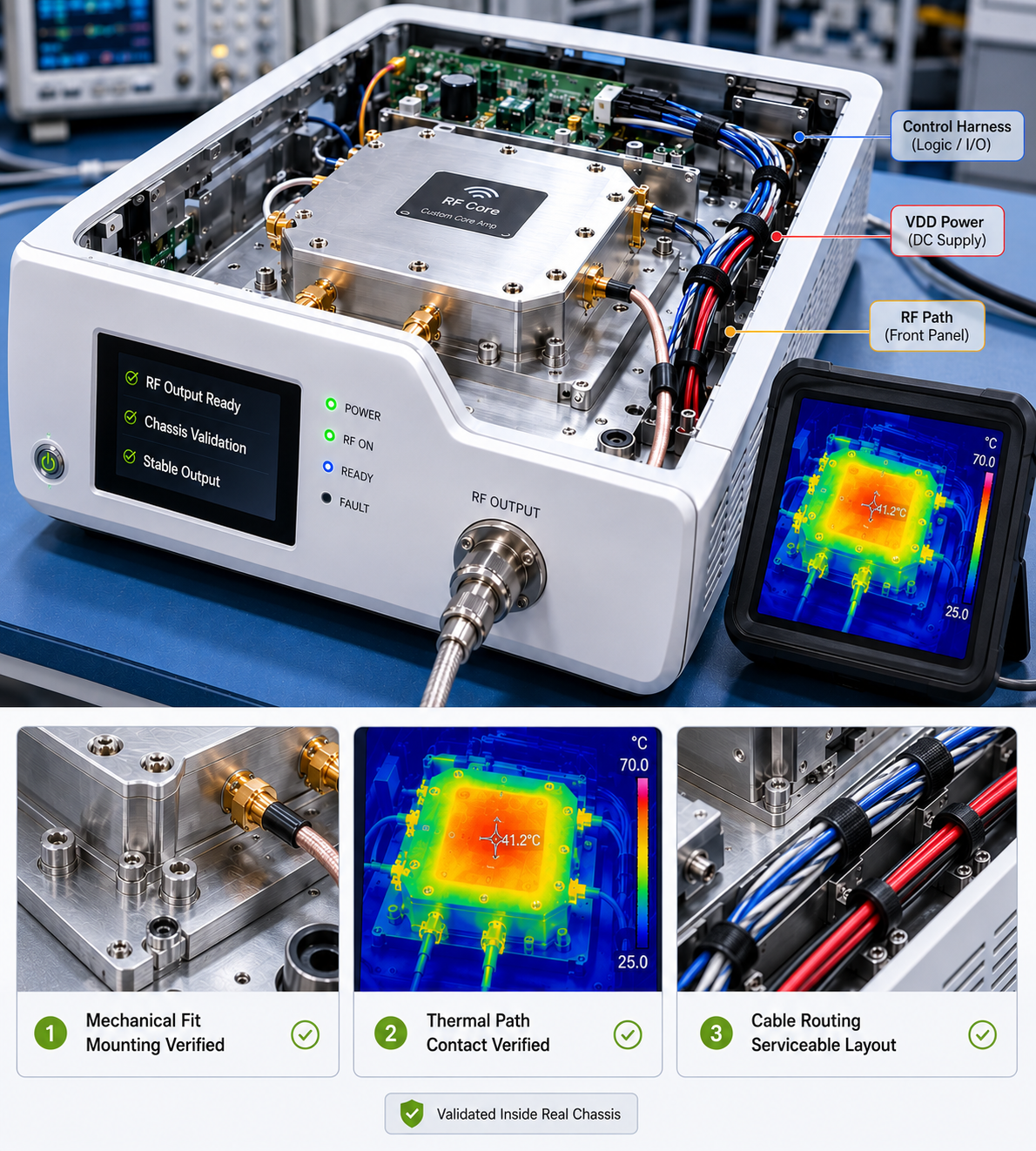

Chassis-level validation of RF core mounting thermal path and cable routing inside a medical RF generator

This phase confirmed that the RF repair was not only electrically correct, but usable inside the customer’s real medical generator chassis.

View Factory Validation
Phase Verification 3

Factory Burn-In and Unit-Level Traceability Before Delivery

Before release for OEM reintegration, each RF core passed factory-side validation covering power output, spectrum review, thermal behavior, protection response, burn-in records, and serial-number traceability.

01 Configuration
Check
02 Power
Test
03 Spectrum
Review
04 Thermal
Burn-In
05 Protection
Test
06 S/N Report
Released
Full-load burn-in test for RF core modules before OEM delivery

Full-Load Burn-In

Each RF core was operated under defined load and duty conditions before release. Burn-in helped screen early instability, thermal drift, and output variation before the unit reached the OEM bench.

Early instability was screened before the RF core reached the OEM bench.
Spectrum power and thermal validation records for RF core factory release

Spectrum / Power / Thermal Record

Factory records captured output power, spectrum behavior, thermal response, and protection status. The acceptance basis moved from verbal confirmation to measured evidence.

The acceptance basis moved from verbal promise to measured record.

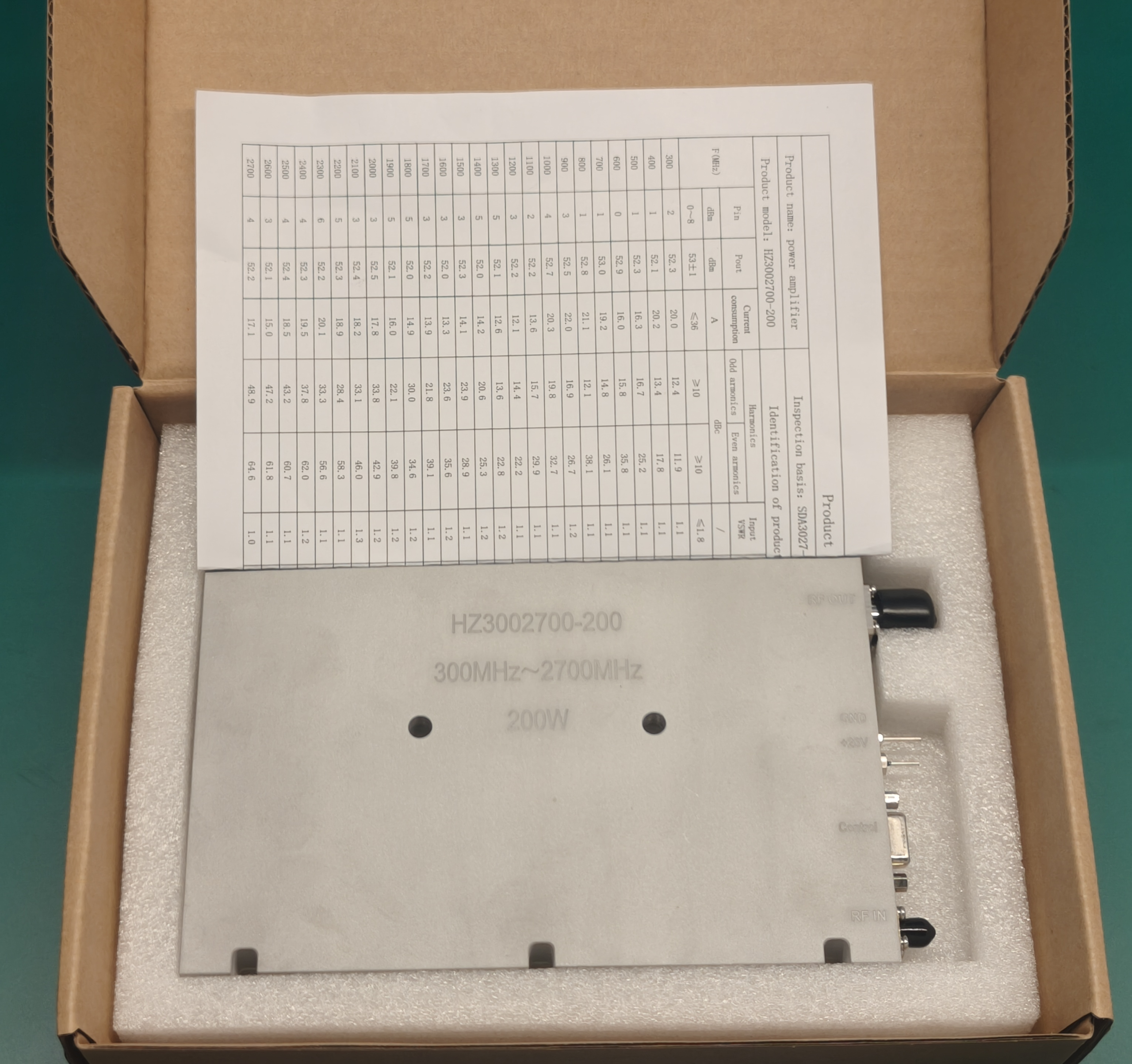

Serial number traceability label and test record for delivered RF core

Serial Number Traceability

Each delivered RF core was linked to a serial-number-based test record, allowing the OEM to trace configuration, validation data, and factory release status for each unit.

Every delivered RF core carried its own engineering history.

Every customized RF core must match real enclosure limits, heat paths, and duty-cycle conditions before production validation begins.

Check Your RF Core Fit
Project Outcome

Measured Results After RF Core Replacement

After the controlled RF-core replacement, the prototype moved from unstable bench behavior to a measurable, protected, and integration-ready RF subsystem. Final acceptance was based on waveform, spectrum, output delivery, protection logic, chassis fit, and factory traceability.

PWM Ready

Pulsed RF Control Restored

Stable PA enable / disable behavior under PWM operation, reducing pulse-edge instability during prototype validation.

Output Path Verified

Front-Panel Output Stabilized

The RF path was corrected from PA output to front-panel output, reducing hidden internal loss and improving repeatable energy delivery.

Spectrum Checked

Harmonic Leakage Suppressed

Measured spectrum review confirmed reduced harmonic and spurious peaks around the intended RF output.

Fail-Safe Logic

Protection Logic Activated

VSWR, reflected power, thermal, voltage, current, alarm, shutdown, and reset logic were integrated into the OEM control architecture.

Chassis Verified

Chassis-Level Fit Confirmed

Mounting, cable routing, thermal contact, and front-panel RF geometry were verified inside the customer’s real generator chassis.

S/N Report

Traceable Delivery Package Released

Each RF core was released with factory-side validation records covering output, spectrum, thermal behavior, and protection response.

The project did not simply replace an amplifier. It converted an unstable RF section into a verified medical OEM energy subsystem.

Have a similar prototype failure? Submit your RF chain constraints before redesigning the entire generator.

Submit Similar Case for Review
Scalable Architecture

From One Generator Rescue to Multiple Medical RF Platforms

The CleanPulse project created more than a repaired prototype. It established a reusable RF energy-core architecture that can be adapted across medical and life-science platforms requiring clean spectrum, pulsed control, protected output, and OEM-level command access.

Verified RF Energy Core

RF Diathermy Generator

Requires stable CW / pulsed RF output, predictable front-panel energy delivery, and thermal stability inside compact desktop equipment.

Electrosurgery Generator

Requires fast pulse response, clean switching behavior, and protection against load mismatch during cutting or coagulation modes.

Microwave Ablation Platform

Requires high-density RF power, reflected-power protection, thermal control, and consistent output under variable tissue-load conditions.

Laboratory Plasma Equipment

Requires stable RF delivery, impedance tolerance, long-duration operation, and controllable interface logic for research platforms.

OEM Platform Upgrade

Legacy generators can be upgraded from unstable amplifier sections to standardized RF-core subsystems without redesigning the entire device.

The same replacement logic can be adapted to different frequency, power, pulse, and thermal constraints.

Check Application Fit
Production Roadmap

From Prototype Rescue to Production RF Core

The CleanPulse case was structured as more than a one-time repair. After the unstable RF section was replaced and verified, the same architecture could support pilot builds, production configuration, and future platform upgrades.

A successful RF rescue should not end at one prototype. It should become a reusable production architecture.

Plan Your RF Lifecycle
Stage 01

Failure Audit

Identify why the first RF chain failed.

Stage 02

Controlled Replacement

Replace the unstable RF section without rebuilding the full generator.

Stage 03

Prototype Re-Validation

Verify signal, spectrum, chassis, and protection behavior.

Stage 04

Pilot Build Support

Standardize wiring, reports, and configuration for pilot production.

Stage 05

Platform Upgrade

Extend the architecture to future medical RF platforms.

Before Rebuilding the Whole Generator, Audit the RF Core First

If your prototype shows unstable pulsed output, harmonic leakage, front-panel power drop, reflected-power alarms, or thermal drift, the issue may not require a full generator redesign. A controlled RF-core audit can identify whether the failure comes from switching behavior, RF path loss, mismatch protection, thermal design, or interface architecture.

!
Unstable pulsed output under PWM mode
!
PA output normal, front-panel output drops
!
Harmonic or spurious peaks block validation
!
Open / short load triggers reflected-power fault
!
Sealed chassis causes long-run thermal drift
Medical RF Core Evaluation
[Medical Grade Frequency Range: 30MHz - 20GHz]

Submit Your Medical RF Core Evaluation

Share your generator constraints, RF output targets, load conditions, control interface, and thermal limits. Our engineering team will evaluate whether your prototype requires RF-core replacement, output-path correction, protection logic redesign, or a fully customized RF energy subsystem.

What Our Engineers Review

RF Chain Failure Source

Whether the problem comes from PA behavior, RF path loss, load mismatch, or control timing.

Output Correction Feasibility

Whether front-panel output can be restored through RF-core replacement and gain/path correction.

Protection Logic Requirement

Whether VSWR, reflected power, thermal, voltage, or current interlocks must be redesigned.

Medical-Grade Manufacturing Pillars

30+ Years RF Heritage

Source factory's deep accumulation in high-frequency medical RF.

0.01mm Precision SMT

Guarantees absolute consistency of clinical equipment core modules.

Strict EMC/FDA Hardening

Architected specifically to pass medical device compliance certifications.

4-Week Rapid Sprint

Meeting high-efficiency iteration from prototype to pilot for medical R&D.
